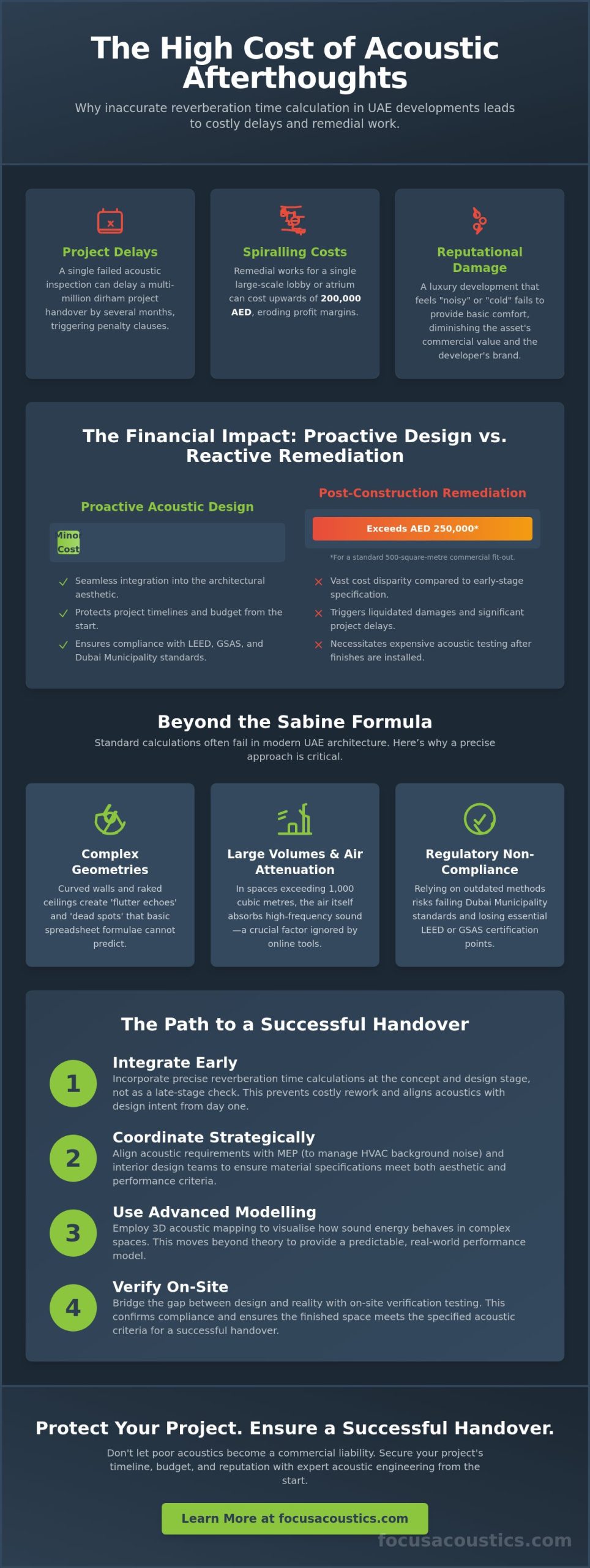

The Commercial Reality of Reverberation Time Calculation in Middle East Developments
Why do developers across the UAE keep treating reverberation time as a snagging issue rather than a design input? On premium projects in Dubai and Abu Dhabi, the gap between an architectural render and the actual user experience usually traces back to acoustic decisions that nobody owned at Concept Design. By the time a room sounds wrong, the marble is laid, the joinery is fixed, and the remedial cost on a single lobby or atrium runs into hundreds of thousands of dirhams.
A clean minimalist aesthetic and a controlled acoustic environment aren’t in conflict. They just need a precise reverberation time calculation early enough to inform the finish schedule. This article covers the commercial cost of getting it wrong, the limits of generic calculation methods on Middle East developments, the coordination required between acoustics, MEP, and interior design, and how on-site verification turns design intent into delivered performance.
Key Takeaways
- Why imprecise reverberation calculations push projects into expensive late-stage remedial works that hit margin and reputation.
- Why the standard Sabine formula isn’t enough for high-volume Middle East developments, and what to account for instead.
- How a precise reverberation time calculation needs to sit alongside MEP design, not behind it.
- Why on-site verification testing is the only thing that confirms the design landed in reality.
- How early coordination with MEP and interior design teams keeps the programme intact and the spec stable.
- Access to a simple reverberation time calculator to provide an easy to understand, high level estimate of your room’s reverberation time.
Table of Contents
-
The Hidden Cost of Inaccurate Reverberation Time Calculation
-
Strategic Coordination: Integrating Acoustics with MEP and Interior Design
-
Verification and Handover: Bridging the Gap Between Design and Reality
The Hidden Cost of Inaccurate Reverberation Time Calculation
A failed acoustic handover in a Dubai high-rise isn’t a technical detail. It’s a programme failure that triggers liquidated damages, eats into margin, and damages the relationship with the client. Most of the time, it traces back to a flawed reverberation time calculation that nobody questioned at Schematic Design. RT60, the time taken for sound to decay by 60 decibels, is the metric that drives whether the space feels usable or feels like an old train station platform. If the input numbers are wrong at Schematic, every downstream decision compounds the error. The reverberation time explained reference is straightforward; the design discipline to deliver against it isn’t.
Skipping an acoustic strategy at Concept Design builds up what’s worth calling acoustic debt. The cost is invisible until handover, then it’s all anyone talks about. In hospitality and high-end residential, the experience is the product. A premium restaurant with the wrong reverberation time can’t hold its covers or its pricing. A signature lobby that echoes loses the first impression it was designed to make. Acoustic comfort is part of the asset value. Once it’s missing, the only routes back are retrofit or compromise, and neither is cheap.
Regulatory Pressures and Compliance Risks
Regional standards aren’t optional anymore. Acoustic targets feed directly into LEED and WELL credits, both becoming more standard requirements on Tier 1 UAE developments. Designing without a verified reverberation time calculation puts those credits at risk. When the issue surfaces at acoustic testing and verification stage, the finishes are already installed, and identifying the cause becomes forensic work. That means time, cost, and disruption a coordinated design would have avoided entirely.
The Financial Impact of Retrofitting
The cost gap between specifying the right material at Schematic Design and retrofitting it at handover is significant. Get the absorption coefficients into the design at the right point and the acoustic treatment can be integrated into the architectural intent. Catch the problem after handover and remedial works on projects can cause remedial works that are multiple times the original installation cost. With unfixed issues that carry to operational stage, the reputational cost that doesn’t show up on a variation order, usually leads to the developer’s next project paying for it.
The Science of Sound Decay: Beyond the Sabine Formula
A precise reverberation time calculation comes down to two things: the volume of the space and the total absorption inside it. The relationship is linear and unforgiving. Double the volume without doubling the absorption and the reverberation time will increase significantly. In the high-volume lobbies favoured across Dubai’s luxury developments, this scales hard. Three variables drive the result: the surface area of every material, their absorption coefficients across the frequency range that matters, and (in larger spaces) air attenuation, which absorbs high-frequency energy in a way basic online tools don’t account for.
Generic calculators typically assume rectangular rooms with diffuse sound fields. Most premium UAE architecture doesn’t oblige. Curved walls, raked ceilings, double-height voids, and complex geometries create focusing effects, flutter echoes and dead zones that no spreadsheet will catch. International benchmarks like the UK Department for Education acoustic standards give a useful target framework for educational and public facilities. The real work is moving from the formula to a 3D acoustic model that shows where the energy actually goes and where the room fights back.
Choosing the Right Calculation Method
Whilst there are several different methods for reverberation time calcaultion, the two most common are Sabine and Eyring. The Sabine method is the default for spaces with low, evenly distributed absorption. Tiled corridors, traditional atriums, lobbies dominated by hard finishes. It overestimates reverberation time once absorption gets significant. For private cinemas, recording studios, or any heavily treated room in Jumeirah or beyond, Eyring gives a more accurate result by accounting for the higher rate of energy lost per reflection. Pick the wrong formula at Schematic Design and you either over-specify the absorption (paying for treatment the room didn’t need) or under-specify it (and find out at handover).
| Room Type | Recommended Formula | Acoustic Environment |
|---|---|---|
| Hotel Lobbies / Atriums | Sabine | Diffuse, reflective, high-volume |
| Cinemas / Auditoria | Eyring | Highly absorbent, controlled |
| Standard Offices | Sabine | Mixed finishes, moderate absorption |
The Role of Absorption Coefficients amongst Hard Finishes
The Middle East aesthetic favours hard finishes. Marble, polished concrete, full-height glass. These materials absorb between 1% and 5% of incident sound energy. The rest reflects. A balanced reverberation time calculation across this kind of palette only works if the design is built around the absorption coefficients of every specified material, not just the ones on a feature wall. The common assumption that any soft finish solves the problem doesn’t account for the full frequency spectrum. Thin carpet and lightweight curtains absorb high frequencies and leave the low-frequency boom in place. The result is a room that still feels uncomfortable, just at a different point in the spectrum.
Insight Layer: The Soft Material Trap
Project teams often assume any soft finish will fix reverberation. Then 3 mm acoustic fabric goes onto a concrete wall and the low-frequency problem stays exactly where it was. The thickness of the absorber and the air gap behind it usually matter more than the surface texture. Working from headline NRC numbers without looking at octave-band data is what creates the costly redesign at snagging. You can discuss your material specifications with our team before procurement closes.

Strategic Coordination: Integrating Acoustics with MEP and Interior Design
Acoustic performance fails when MEP and architecture run on separate workstreams. A common pattern in UAE developments is acoustic masking, where high HVAC background noise hides the underlying room behaviour. The contractor balances the system, the noise drops to NC-30 or NC-35, and suddenly the echo is the only thing anyone hears. By that point, the reverberation time calculation that should have happened at Schematic Design is being run during snagging, and the cost of the fix can be three to four times what it would have been at design. The MEP coordination needs to align with the acoustic targets early, not be reconciled with them later. The standard reverberation time targets are not negotiable once the room is in use.
The acoustic foam trap is the other common failure mode. Late-stage reverberation problems get solved with surface-mounted foam, and the interior design takes the hit. Treating acoustics as an architectural input from Concept Design avoids that entirely. Within proper architectural acoustics services, materials with strong absorption characteristics can be specified to disappear into the design. Micro-perforated timber, acoustic plaster, and fabric-wrapped panels read as solid surfaces while doing the acoustic work behind them.
Managing Large Volumes and Open-Plan Spaces
Hotel lobbies, residential atriums, and grand entrance volumes in Dubai are typically finishes in glass, stone and metal – materials that reflect most of the sound that hits them. Treating these volumes without compromising the visual aesthetic means using hidden absorption. Micro-perforated timber panels, acoustic plasters, and panel systems behind decorative finishes all deliver high absorption while reading as solid materials. Strategic placement on non-visible planes (high-level bulkheads, undersides of mezzanines, soffits behind fins) keeps the reverberation time calculation tight without forcing the architecture to compromise.
Verification and Handover: Bridging the Gap Between Design and Reality
A theoretical reverberation time calculation is a prediction. It’s not proof of performance. The transition from a 3D acoustic model to a finished space is where most acoustic intent gets lost. Material substitutions, installation tolerances, and value engineering decisions all chip away at the design unless someone is checking. Verification confirms the design survived contact with construction. Without it, the developer is taking the contractor’s word for something that costs hundreds of thousands of dirhams to fix once it’s wrong.
The On-Site Verification Process
Verification needs more than a handheld meter. The proper process uses standardised, high-output sound sources and Class 1 calibrated microphones to measure RT60 across the full frequency spectrum, not just an A-weighted average. The output identifies exactly where the as-built diverges from the design. On many UAE developments, this measurement is mandatory for municipality sign-off or to satisfy LEED, WELL, or similar credit requirements. When discrepancies show up, they usually trace back to specific construction defects. Unsealed voids behind treatments. Panels mounted without the design air gap. A substitute board that lost a few decibels of absorption. Acoustic testing and verification surfaces these before they become litigation.
Closing the Loop: Construction Support
Active site presence during the fit out phase is the cheapest way to manage acoustic risk. Waiting until handover to test is a high-risk strategy that turns minor installation errors into expensive remedials. Construction support and close-out catches those issues while they’re still cheap. Something as simple as omitting an air gap behind a timber slat wall can cut the design absorption by 40% or more. Without site oversight, that error stays invisible until someone notices the room sounds wrong, by which point the only fix is to take it apart.
Delivering Commercial Certainty through Acoustic Precision
Simplified models for reverberation time calculation can have their place early on in projects, however reliance on these for more complex requirements create commercial risk that may not show up until that risk is realised. When a project misses Dubai Municipality targets or hospitality operator standards at handover, the cost of remedial works typically lands at multiples of the original acoustic budget. Most of that cost is avoidable. The decisions that drive RT60 sit at Concept and Schematic Design, where the cost to change anything is low and the impact on the finish package is minimised. Focus Acoustics has worked across major UAE, KSA, and Qatar developments to keep that decision-making in the right place.
Acoustic comfort isn’t a layer to add at the end. In luxury residential and hospitality, it’s part of the product. Coordinating acoustics with MEP and interior design from Pre-Concept onwards is the only route to an asset that performs as designed. Our independent consultancy bridges design intent and built reality so the project hands over without surprises and the developer doesn’t spend handover week explaining why a signature space doesn’t work.
Consult with our specialist acoustic advisors to secure your project handover
The cost of getting acoustics right at Concept is small. The cost of getting it wrong at handover isn’t.
Frequently Asked Questions
What is the ideal reverberation time for a commercial office space?
For a standard office in Dubai, the target sits between 0.6 and 0.8 seconds. With meeting rooms or video conferencing facilities included, the range tightens to 0.4 to 0.6 seconds for usable speech clarity. The targets align with ISO 3382 and similar international standards. Miss them and you get the symptoms most occupants describe as "tiring" or "noisy" without being able to point at a cause.
Can I calculate reverberation time myself using a free online tool?
For a rough estimate on a simple room, yes. We have provided a free tool here. However, for commercial compliance or any complex architectural geometry, no. Online tools typically do not handle more complex sound fields, specific mounting methods or absorption behaviour of specific finishes, or unevenly distributed placement of finishes. Whilst we have provided our tool for information purposes, a simple reverberation time calculation from a free tool isn’t something you can drive procurement on for a high-value development. However, we do want to promote acoustic understanding, so our tool allows you to understand the effect of different basic finishes in a cuboid space on the overall reverberation time.
How does room volume affect the reverberation time calculation?
Volume drives the result directly. The more cubic metres of space, the more sound energy the room holds, and the more total absorption it needs to control decay. Add height to a lobby without adding absorption and RT60 climbs in proportion. That’s why high-volume atriums in Dubai need the absorption strategy locked at Concept Design, not added in at snagging. The reverberation time calculation simply won’t behave otherwise.
What is the difference between RT60 and NRC?
RT60 measures how long it takes a sound to decay by 60 decibels in a room. It’s a property of the space. NRC, or Noise Reduction Coefficient, is a single-figure rating between 0 and 1 that describes how much sound a specific material absorbs in a lab test. NRC is an input. RT60 is the output you’re trying to hit. Picking a high-NRC product without checking the room volume and surface area won’t deliver the target.
Why do my on-site measurements differ from the initial design calculations?
Lab test data comes from controlled mounting conditions that real construction sites don’t replicate. Different adhesives, different mounting depths, different air gaps, and different tolerances all shift the absorption away from the brochure figure. We’ve seen site-verified results land more than 20% off the design model when the installation deviated from the specification. Mock-up testing during the fit out phase catches that gap before it becomes a building-wide problem.
Is it possible to reduce reverberation time without changing the interior design?
Yes. Acoustic plasters, micro-perforated timber, and panel systems behind decorative finishes all deliver high absorption while reading as solid materials. Absorption can also be integrated into joinery linings, into furniture upholstery, or behind decorative screens. Used well, none of this is visible. It’s the standard approach for premium commercial lobbies where the visual cleanliness has to hold.
